Strategic mine planning is the backbone of a mining feasibility study. It transforms a geological resource into a time‑phased, risk‑aware business plan that supports investment, design, permitting, financing, and closure decisions (Morales et al., 2019; Dowd, Xu and Coward, 2016).

1. Strategic Mine Planning: Definition and Scope

Strategic mine planning is the long‑term, life‑of‑mine (LOM) planning process that determines:

  • Which part of the resource will be mined (ultimate pit / underground extent)
  • In what sequence and at what extraction rate material will be mined and processed
  • With which capacities, configurations, and investments (fleets, plants, infrastructure)
  • Under what assumptions about markets, costs, technology, environmental and social obligations

For open pits, two core problems dominate (Morales et al., 2019; Dowd, Xu and Coward, 2016):

  • Ultimate pit limit problem – define the mineable reserve within geotechnical and economic constraints
  • Life‑of‑mine production scheduling – decide when to extract each block/panel to maximize net present value (NPV) subject to capacity, quality, and other constraints

Strategic planning now extends beyond economic and technical factors to include environmental and closure costs, regulatory frameworks, and sustainability objectives (Oliveros-Sepúlveda, Bascompta-Massanés and Franco-Sepúlveda, 2025).

2. Role and Purpose in a Mining Feasibility Study

At pre‑feasibility and feasibility level, the strategic mine plan is not just a technical deliverable; it is the central integrating element of the study.

2.1 Establishing Technical and Economic Viability

A feasibility study must show that a project is technically feasible and economically worthwhile with an acceptable risk profile. Strategic planning provides (Marković et al., 2025; Morales et al., 2019; Dowd, Xu and Coward, 2016):

  • Reserves and mine life: conversion of resources into economically mineable reserves, with pit/underground limits and life‑of‑mine horizon
  • Production profiles: annual or period‑by‑period ore, waste, grades, and product tonnages
  • Cash‑flow basis: time‑phased revenues, OPEX, CAPEX, sustaining and closure costs feeding NPV and IRR calculations (Marković et al., 2025; Oliveros-Sepúlveda, Bascompta-Massanés and Franco-Sepúlveda, 2025)Hybrid deterministic–stochastic models have demonstrated that deterministic feasibility outputs can be misleading. In a polymetallic open‑pit case, deterministic optimization yielded NPV of USD 130.8 M, while a stochastic model gave a mean NPV of USD 155.5 M with a standard deviation of USD 76.5 M, and revealed a 3 % probability of overall project unprofitability (Marković et al., 2025). This kind of analysis is central to a high‑quality feasibility study.

2.2 Sizing and Phasing Investments and Capacities

Strategic mine plans drive major capital decisions:

  • Fleet size and timing of acquisitions
  • Plant capacity and debottlenecking (crushers, mills, concentrators)
  • Expansion options and their triggers

In a copper open‑pit complex, a multistage stochastic model identified optimal branching investment strategies (truck/shovel fleet changes and a secondary crusher) that increased expected NPV by more than US$170 M compared with a simpler two‑stage approach (Del Castillo and Dimitrakopoulos, 2019). Feasibility studies that ignore such dynamic investment options may under‑ or over‑invest.

2.3 Selecting Mining Options and Configurations

For deposits amenable to both open‑pit (OP) and underground (UG) mining, feasibility studies must determine:

  • Optimal choice among OP only, UG only, OP→UG, UG→OP, or simultaneous OP+UG
  • Transition depth/location, crown pillar location, and extraction sequence
  • Life of mine, strip ratio, blending strategy, and production smoothness as performance indicators (Afum and Ben-Awuah, 2021)A review of surface–underground options highlights the need for integrated (often stochastic) models at the prefeasibility stage to evaluate these configurations with indicators such as NPV, IRR, discounted cash flow, blending ratio, and mine life (Afum and Ben-Awuah, 2021).

2.4 Integrating Environmental, Social, and Closure Considerations

Historically, feasibility‑level planning treated environmental and closure costs as peripheral. Recent work shows these are now core strategic variables (Oliveros-Sepúlveda, Bascompta-Massanés and Franco-Sepúlveda, 2025):

  • Environmental and closure costs can materially affect NPV/IRR and even reserve definitions (Oliveros-Sepúlveda, Bascompta-Massanés and Franco-Sepúlveda, 2025)- Premature project termination due to environmental or social issues often leads to higher closure costs than planned progressive closure (Oliveros-Sepúlveda, Bascompta-Massanés and Franco-Sepúlveda, 2025)- Sustainable post‑mining land use must be planned strategically using tools such as SWOT and IE matrices, defining strategies for each land‑use option (Amirshenava and Osanloo, 2022)A Peruvian case study showed that integrating an advanced water quality model and closure cost tools into planning enabled ranking mine plans according to long‑term water quality impacts and associated mitigation costs, aligning short‑ and long‑term plans with closure objectives (Sanders and Fitzpatrick, 2022).

2.5 Supporting Project Finance, Permitting, and Social License

Strategic mine plans are used to:

  • Convince lenders and investors that cash‑flows are robust to key uncertainties (Marković et al., 2025; Del Castillo and Dimitrakopoulos, 2019)- Demonstrate to regulators that waste, water, and closure are planned consistently with legal requirements and policies (Oliveros-Sepúlveda, Bascompta-Massanés and Franco-Sepúlveda, 2025)- Show communities and stakeholders a credible trajectory from construction to closure, including post‑mining land use (Amirshenava and Osanloo, 2022; Sanders and Fitzpatrick, 2022; Oliveros-Sepúlveda, Bascompta-Massanés and Franco-Sepúlveda, 2025)Without a rigorous strategic plan embedded in the feasibility study, these commitments lack quantitative backing.

3. Key Parameters in Strategic Mine Planning

Strategic mine planning uses a large, interdependent set of parameters. At feasibility level, their accuracy, uncertainty characterization, and inter‑dependencies are critical.

3.1 Geological and Geometallurgical Parameters

Block model: The core input is a 3D block model with attributes such as (Morales et al., 2019; Dowd, Xu and Coward, 2016):

  • Tonnage (volume × density)
  • Grades of economic and deleterious elements
  • Lithology, alteration, rock type, structural domains
  • Geotechnical domains (strength, RMR/Q, joint sets)
  • Geometallurgical variables – recovery, hardness, comminution specific energy, mineralogy

Traditionally, block attributes are deterministic estimates (e.g., kriging). Modern approaches:

  • Use equiprobable simulated realizations to represent grade and geometallurgical uncertainty (Morales et al., 2019; Dowd, Xu and Coward, 2016)- Build geometallurgical models capturing spatial variability of recovery, hardness, and comminution energy, sometimes through multiple scenarios (Quelopana et al., 2023; Mata, Nader and Mazzinghy, 2022)Incorporating geometallurgy and its uncertainty can change both pit limits and schedules, with measurable financial impact (Morales et al., 2019; Dowd, Xu and Coward, 2016; Mata, Nader and Mazzinghy, 2022).

3.2 Economic and Market Parameters

Key economic parameters include:

  • Commodity price forecasts and ranges
  • Operating costs: mining, processing, G&A, logistics
  • Capital costs: initial, expansion, sustaining, closure
  • Discount rate, tax and royalty regimes, exchange rates

Hybrid deterministic–stochastic frameworks characterize these parameters using probability distributions (often via Monte Carlo sampling) instead of single values, explicitly quantifying uncertainty in cash‑flows and NPV (Marković et al., 2025; Sepúlveda, Álvarez and Bedoya, 2020).

3.3 Technical and Design Parameters

Important design and operating constraints include:

  • Slope design: bench and inter‑ramp angles, controlling pit shape and depth (Morales et al., 2019; Dowd, Xu and Coward, 2016)- Mining capacity: annual total material movement limits, ore mining capacity, waste stripping capacity by equipment and infrastructure (Del Castillo and Dimitrakopoulos, 2019; Morales et al., 2019; Mata, Nader and Mazzinghy, 2022)- Processing capacity: plant throughput, multiple plant streams, down‑time and maintenance patterns, metallurgical plant modes (Quelopana et al., 2023)- Cut‑off grades: fixed or variable cut‑off strategies, often central decision variables influencing reserve size, mine life, and NPV
  • Stockpiling and blending rules: maximum stockpile capacities, reclaim rates, blending tolerances for grades and contaminants (Del Castillo and Dimitrakopoulos, 2019; Morales et al., 2019; Quelopana et al., 2023)Geomechanical constraints such as haulage ramps, bench widths, minimum mining widths, and controlled strip ratios per period must also be honored; direct block scheduling solutions that ignore these often yield operationally infeasible plans (Morales et al., 2019; Malundamene et al., 2024; Dowd, Xu and Coward, 2016).

3.4 Environmental, Closure, and Sustainability Parameters

Modern strategic planning quantifies:

  • Environmental costs: waste rock and tailings management, water management, emissions and dust control, ecosystem impacts
  • Closure costs: backfilling, capping, recontouring, revegetation, long‑term water treatment, monitoring (Amirshenava and Osanloo, 2022; Sanders and Fitzpatrick, 2022; Oliveros-Sepúlveda, Bascompta-Massanés and Franco-Sepúlveda, 2025)- Regulatory and policy frameworks: environmental standards, bonding requirements, SDG‑aligned policies (Oliveros-Sepúlveda, Bascompta-Massanés and Franco-Sepúlveda, 2025)- Post‑mining land use: parameters defining suitability and vulnerability of land‑use options (agriculture, forestry, renewable energy, recreation, etc.) (Amirshenava and Osanloo, 2022)Environmental and closure costs are no longer exogenous; they directly influence resource/reserve reporting and project economics, and must be represented in strategic optimization models (Oliveros-Sepúlveda, Bascompta-Massanés and Franco-Sepúlveda, 2025).

3.5 Energy and Renewable Integration Parameters

With increasing emphasis on decarbonization, strategic planning now includes:

  • Current and future energy mix (diesel, grid, renewables)
  • Capital and O&M costs of renewable options (PV, wind, storage)
  • Carbon pricing or internal shadow carbon values

A SWOT‑based study shows renewable energy adoption in mining can reduce pollution, create jobs, lower operating costs, and enhance circular economy, though hindered by high initial capital and skills gaps (Pouresmaieli et al., 2023). Such parameters need to be reflected in feasibility‑level scenarios.

4. Strategies and Methods for Optimizing the Mine Plan

Optimization methods have evolved from simple deterministic pit shells to comprehensive stochastic and adaptive frameworks.

4.1 Deterministic Optimization: Baseline Practice

At feasibility, most projects still rely on a deterministic optimization chain:

  1. Pit optimization:
    • Lerchs–Grossmann or equivalent network‑flow algorithms compute ultimate pit shells to maximize undiscounted or discounted profit subject to slope constraints (Anisimov, Bariatska and Cherniaiev, 2024; Morales et al., 2019).
    • Modern software (e.g., Geovia Whittle) generates multiple nested pit shells under varying economic parameters, aiding selection of a final shell even for complex, multi‑ore‑body geometries.
  2. Phase (pushback) design:
    • Intermediate pit shells define stages for operational practicability, controlling working widths, access, and strip ratios over time (Anisimov, Bariatska and Cherniaiev, 2024).
  3. LOM scheduling:
    • Linear / mixed‑integer programming (MIP) or heuristic algorithms schedule blocks/panels over periods, maximizing NPV under capacity, precedence, and blending constraints (Morales et al., 2019; Dowd, Xu and Coward, 2016).
  4. Cut‑off grade and stockpiling policies:
    • Often parametrically optimized (e.g., through nested LPs or heuristics) to maximize NPV while meeting product quality and capacity targets.
NPV Pit Optimization

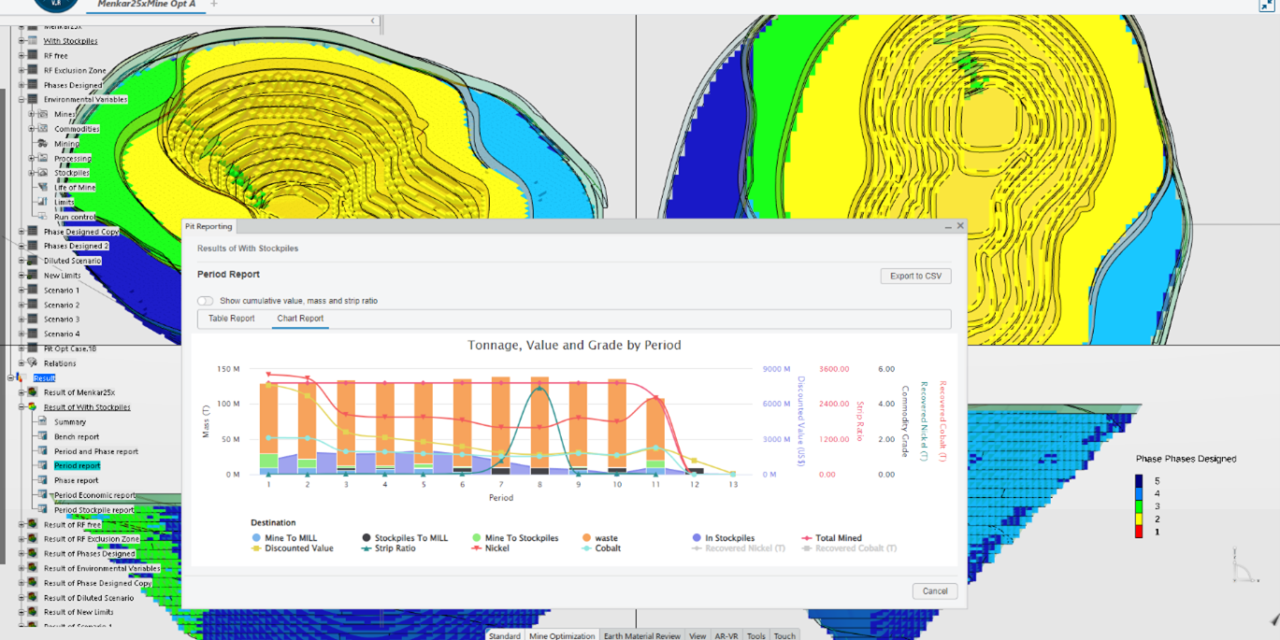

Figure 1: NPV Pit Optimization

Deterministic optimization is computationally efficient and embedded in commercial packages. However, it presumes single‑value inputs and does not quantify risk, leading to potentially misleading “optimal” plans (Marković et al., 2025; Fernanda et al., 2024; Sepúlveda, Álvarez and Bedoya, 2020).

4.2 Stochastic Optimization and Risk‑Based Strategic Planning

Stochastic optimization explicitly addresses geological, technical, and market uncertainty.

4.2.1 Hybrid Deterministic–Stochastic Models with ISO 31000

A hybrid model integrates:

  • Deterministic optimization (base case pit limit and schedule)
  • Stochastic optimization over distributions of key parameters (prices, costs, ore grades)
  • Risk analysis structured by ISO 31000 risk management principles (Marković et al., 2025)Monte Carlo simulation generates distributions for input parameters; these feed a stochastic optimizer that produces NPV distributions, not just a single value. In the cited case, VaR and CVaR show a 3 % probability of project unprofitability despite positive mean NPV, revealing downside risk masked by the deterministic case (Marković et al., 2025).

This supports feasibility‑level decision‑making by:

  • Quantifying downside NPV at chosen confidence levels (e.g., 95 % VaR)
  • Identifying parameters that most drive risk
  • Designing more robust pit limits and schedules

4.2.2 Multistage Stochastic Programming for Mining Complexes

Mining complexes with multiple pits and processing streams face dynamic investment and configuration decisions:

  • Changing fleets, adding crushers, modifying plant capacities
  • Routing ore among multiple plants and stockpiles

A multistage stochastic programming model:

  • Uses a scenario tree with multiple recourse stages
  • Makes sequential investment and operating decisions based on observed information in each period
  • Embeds capital investment variables that activate capacities and costs when chosen

In a copper complex, this approach generated a dynamic strategic plan with branching options for configurations; expected NPV increased by more than US$170 M relative to a two‑stage model, and the solution showed a substantial probability that the mine design should branch rather than follow a single fixed path (Del Castillo and Dimitrakopoulos, 2019).

Adaptive simultaneous stochastic optimization at the Escondida complex likewise used geological simulations and branching plans to produce operationally feasible strategies that adapt to uncertainty, improving value and risk positioning (Fernanda et al., 2024).

4.2.3 Metaheuristics and Simulation‑Based Stochastic Planning

Where exact MIP formulations become intractable, metaheuristic algorithms (variable neighbourhood descent, simulated annealing, evolutionary algorithms) combined with simulation are employed (Sepúlveda, Álvarez and Bedoya, 2020; Quelopana et al., 2023):

  • These methods search large solution spaces for near‑optimal LOM schedules under multiple scenarios.
  • Stochastic open‑pit planning models can include grade and price uncertainty and produce robust schedules that maximize expected profit and mitigate risk (Sepúlveda, Álvarez and Bedoya, 2020).

Research suggests that including additional variables (environmental, social) into these stochastic frameworks would further improve realism (Sepúlveda, Álvarez and Bedoya, 2020).

4.3 Integration of Geometallurgy and Plant Operation

Long‑term planning that ignores geometallurgy can under‑ or over‑estimate project value.

4.3.1 Geometallurgical Scenarios in Pit Limits and Scheduling

A risk‑aware geometallurgical approach (Morales et al., 2019; Dowd, Xu and Coward, 2016):

  • Builds multiple equiprobable scenarios of grades and geometallurgical attributes (recovery, hardness, etc.).
  • Performs pit optimization per scenario, then defines a reliability pit that is feasible across scenarios.
  • Uses stochastic integer programming to schedule blocks from the reliability pit, maximizing expected discounted value and minimizing deviations from production targets (Morales et al., 2019).

Results show that including geometallurgical uncertainty can materially change optimal pit depth, pushbacks, and extraction sequences, thus affecting NPV and risk (Morales et al., 2019; Dowd, Xu and Coward, 2016).

4.3.2 Detailed Plant Modes within Strategic Optimization

To bridge mine and plant optimization, geometallurgical detailing of plant operation has been introduced (Quelopana et al., 2023):

  • The strategic algorithm is adapted (via Dantzig–Wolfe decomposition) to include plant operational modes (e.g., different comminution circuits) as linear sub‑problems.
  • For each geological scenario, the model chooses not only which blocks to mine and when, but also how to process them (mode selection) (Quelopana et al., 2023).

Case calculations based on the Mount Isa deposit show that a plant upgrade can significantly reduce mining equipment requirements without materially affecting NPV, demonstrating that strategic integration of plant modes can change investment and scheduling decisions (Quelopana et al., 2023).

4.3.3 Comminution Specific Energy and Global Optimization

Global optimization that integrates geometallurgical variables such as comminution specific energy into pit, pushbacks, and scheduling steps can yield (Mata, Nader and Mazzinghy, 2022):

  • ~9.7 % increase in NPV and ~5.2 % increase in ore production versus simpler strategies
  • More stable strip ratios and better control of comminution energy over time

This underscores the value of including such variables in block models and optimization objectives at feasibility stage (Mata, Nader and Mazzinghy, 2022).

4.4 Real Options and Strategic Flexibility

Real options treat certain strategic decisions as options rather than fixed commitments.

  • At project level, options include delaying development, staging expansions, scaling capacity, or abandoning (Ali and Rafique, 2024).
  • At planning level, “planning options” include extraction sequences, cut‑off policies, slope modifications, and capacity switches (Ali and Rafique, 2024).

Real options:

  • Transform uncertainty into opportunity by allowing adaptive responses to market and geological changes (Ali and Rafique, 2024).
  • Complement stochastic optimization: while stochastic models produce adaptive plans, real‑options valuation quantifies the value of such flexibility.

The literature highlights that naïve single‑scenario optimization ignores this adaptive capability, whereas flexible designs can reconfigure in response to new information, better matching actual operating conditions (Ali and Rafique, 2024; Fernanda et al., 2024).

4.5 Multi‑Criteria and Sustainability‑Oriented Strategies

Economic objectives (NPV, IRR) increasingly share space with:

  • Resource utilization (rational depletion, recovery)
  • Environmental impact and closure cost
  • Social criteria (employment, community impacts)

A multi‑criteria optimization applied to an underground coal mine combined geological constraints, infrastructure, and economic metrics (NPV, EBIT, FCFF). Millions of scenarios were screened digitally, revealing many better scenarios than the base case; the best scenario had NPV ~50 % higher than the base case, which ranked only 52nd of 60 (Kopacz et al., 2020).

State‑of‑the‑art reviews emphasize operations research methods (LP, dynamic programming, stochastic programming, metaheuristics) as key tools to design sustainable surface mine plans aligned with SDGs (Pouresmaieli et al., 2023; Oliveros-Sepúlveda, Bascompta-Massanés and Franco-Sepúlveda, 2025).

Key Parameters and Optimization Approaches in Strategic Planning

Planning FocusMain Parameters / DecisionsDominant Methods
Pit limits & reservesBlock values, slope design, geotechnical domainsLerchs–Grossmann, network flow, global optimization in software (e.g., Geovia Whittle)
LOM schedulingBlock/panel sequencing, capacities, cut‑offs, stockpilesLP/MIP, stochastic integer programming, metaheuristics
Mining complexes & investmentsFleet, crushers, plant capacities, configuration branchesMultistage stochastic programming, adaptive branching
Geometallurgy & plant modesRecovery, hardness, comminution energy, plant modesScenario‑based geomet models, Dantzig–Wolfe, global optimization
Risk & uncertaintyPrices, costs, grades, geomet, env. costsHybrid deterministic–stochastic with Monte Carlo, VaR/CVaR, ISO 31000
Sustainability & closureEnv./closure costs, PMLU options, energy mixQuantitative closure costing models, SWOT/IE, SDG‑aligned planning

Figure 2: Core decision areas and optimization tools in strategic mine planning.

5. Risks and Potential Losses from Suboptimal Strategic Mine Plans

Suboptimal or naïve strategic mine plans can cause large economic, environmental, and social losses.

5.1 Economic and Financial Risks

5.1.1 Misleading Economic Evaluation and NPV Overestimation

Deterministic models that neglect uncertainty can substantially mis‑estimate project value and risk.

  • In the hybrid risk‑based study, deterministic NPV was USD 130.8 M, but stochastic modelling showed mean NPV of 155.5 M with σ = 76.5 M and a non‑trivial (3 %) probability of project unprofitability (Marković et al., 2025). A feasibility study relying on the single deterministic number would understate downside risk.
  • Stochastic optimization reviews emphasize that deterministic planning tools maximize profit under unrealistic assumptions and do not value risk appropriately (Sepúlveda, Álvarez and Bedoya, 2020).

Investors and lenders may commit capital to projects whose downside risk is much higher than indicated by deterministic feasibility models.

5.1.2 Lost Value from Non‑Optimized Schedules

The coal mine multi‑criteria optimization shows directly the cost of suboptimal plans:

  • The “base case” schedule actually implemented ranked 52nd of 60 generated scenarios.
  • The best scenario achieved NPV nearly 50 % higher than base case, with only small differences (<4 %) in EBIT and FCFF (Kopacz et al., 2020).

This demonstrates that failure to use advanced optimization at the strategic stage can leave huge value unrealized, even when the plan appears reasonable.

5.1.3 Inflexibility in a Dynamic Environment

Single‑assumption optimization produces plans that may be far from optimal once reality diverges from assumptions (Ali and Rafique, 2024; Fernanda et al., 2024). Risks include:

  • Under‑ or over‑investment in fleets and plants
  • Inability to respond to price downturns or upswings
  • Poor sequencing decisions that are difficult or impossible to reverse once built

Adaptive stochastic optimization at Escondida shows that allowing the plan to branch and adapt to geological information yields higher expected NPV and a design better poised to handle regulatory and climate‑related changes (Fernanda et al., 2024). Without such flexibility, mines risk stranded capital and misaligned capacity.

5.2 Technical and Operational Risks

5.2.1 Operationally Infeasible Plans

Direct block scheduling at fine block resolution maximizes value mathematically, but often generates extraction sequences that:

  • Violate minimum operating width or geotechnical constraints
  • Produce unsustainable period‑by‑period strip ratios
  • Cannot be implemented with actual equipment and access conditions (Morales et al., 2019; Malundamene et al., 2024; Dowd, Xu and Coward, 2016)If feasibility planning does not rigorously convert schedules into valid designs, operational difficulties, delays, and redesign costs may arise in early production, eroding projected NPV.

5.2.2 Poor OP/UG Transition and Resource Utilization

A review of OP–UG transitions reveals that many existing tools are still deterministic and simplistic, failing to consider stochastic uncertainty or integrated constraints (safety, hydrogeology, waste management, blending) (Afum and Ben-Awuah, 2021). Risks include:

  • Leaving economic ore unrecovered (sub‑optimal transition depth/crown pillar)
  • Unsafe or costly interactions between surface and underground operations
  • Suboptimal blending of high‑grade UG ore and lower‑grade OP ore, reducing overall value (Afum and Ben-Awuah, 2021)
Poor OP UG Transition and Resource Utilization

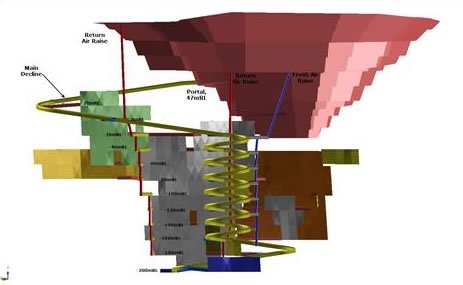

Figure 3: Open Pit & Underground Mine Transition and Resource Utilization

5.2.3 Underestimated Closure and Environmental Liabilities

A recent review shows that as sustainable development frameworks have matured, environmental and closure costs now materially affect reserve estimates and NPV (Oliveros-Sepúlveda, Bascompta-Massanés and Franco-Sepúlveda, 2025):

  • Premature closure or shutdown due to environmental or social conflict often causes higher closure costs than phased, well‑planned closure (Oliveros-Sepúlveda, Bascompta-Massanés and Franco-Sepúlveda, 2025).
  • If feasibility studies exclude rigorous environmental and closure cost modelling, companies risk large unplanned liabilities later in the life, damaging profitability and reputation.

The Peruvian case with integrated water quality modelling illustrates how mine plans with apparently similar economics can differ markedly in long‑term water treatment needs and closure costs (Sanders and Fitzpatrick, 2022).

5.2.4 Unsustainable Post‑Mining Land Use

Strategic planning of post‑mining land use using SWOT and IE matrices identified:

  • Dozens of strengths, weaknesses, opportunities, and threats for each land‑use option
  • The best strategic position in one case was for non‑renewable energy use, but 32 strategies were needed across eight options to ensure sustainable deployment (Amirshenava and Osanloo, 2022)Without such structured analysis at feasibility stage, PMLU selections may have high vulnerabilities, threatening long‑term social license and success of reclamation.

5.2.5 Missed Opportunities in Energy Transition

The SWOT study on renewable energy in mining concludes that:

  • Strengths and opportunities (pollution reduction, lower operating costs, job creation, circular economy potential) outweigh weaknesses and threats (high CAPEX, skill shortages) (Pouresmaieli et al., 2023).
  • An aggressive strategy leveraging these positives is recommended (Pouresmaieli et al., 2023).

Feasibility studies that do not evaluate renewable integration may lock operations into expensive, carbon‑intensive energy systems, increasing future carbon costs and jeopardizing ESG performance.

5.4 Organizational and Governance Risks

5.4.1 Over‑Reliance on Tools, Under‑Reliance on Expertise

Despite algorithmic advances, mining companies face limited capabilities and must often make significant compromises in strategic planning. A central message is the critical role of skilled professionals to interpret and constrain models correctly; otherwise, planners risk misusing optimization tools, leading to poor decisions (King, 2011).

Suboptimal governance can manifest as:

  • Misunderstanding stochastic and real‑options outputs
  • Failing to align strategic, medium‑, and short‑term plans
  • Insufficient integration between technical teams (geology, mine, plant, environment, finance)

5.4.2 Risk Management Gaps

Risk‑aware planning guided by ISO 31000 involves structured steps of risk identification, analysis, evaluation, and treatment (Marković et al., 2025). Without embedding such processes:

  • Critical risks (geological, price, closure) may be under‑analyzed
  • Decision‑makers receive point estimates instead of risk distributions and VaR/CVaR metrics (Marković et al., 2025; Oliveros-Sepúlveda, Bascompta-Massanés and Franco-Sepúlveda, 2025; Sepúlveda, Álvarez and Bedoya, 2020)- Corporate strategies remain exposed to “black swan” events in markets or regulation

6. Implications and Directions for High‑Standard Strategic Planning

Maintaining high research and technical standards in feasibility‑level strategic planning implies:

  1. Use stochastic and hybrid models wherever material uncertainty exists, especially for large capital projects and complex deposits (Marković et al., 2025; Del Castillo and Dimitrakopoulos, 2019; Morales et al., 2019; Fernanda et al., 2024; Sepúlveda, Álvarez and Bedoya, 2020).
  2. Explicitly integrate geometallurgy, plant behavior, and comminution energy into planning, not just grade and tonnage (Morales et al., 2019; Quelopana et al., 2023; Dowd, Xu and Coward, 2016; Mata, Nader and Mazzinghy, 2022).
  3. Treat environmental, closure, and social factors as core economic variables, embedding them in NPV/IRR calculations and reserve estimates (Amirshenava and Osanloo, 2022; Sanders and Fitzpatrick, 2022; Oliveros-Sepúlveda, Bascompta-Massanés and Franco-Sepúlveda, 2025).
  4. Incorporate real options and adaptive design principles so mine plans can change path as information and external conditions evolve (Ali and Rafique, 2024; Fernanda et al., 2024).
  5. Adopt multi‑criteria optimization where resource utilization, production smoothness, and ESG metrics matter alongside NPV (Kopacz et al., 2020; Pouresmaieli et al., 2023; Afum and Ben-Awuah, 2021).
  6. Ensure vertical integration of planning horizons – strategic, medium‑term, and short‑term – using modern optimization methods to maintain alignment and manage day‑to‑day deviations (Malundamene et al., 2024; Dowd, Xu and Coward, 2016; Mata, Nader and Mazzinghy, 2022).
  7. Invest in people and governance so that advanced models are used critically, not blindly (King, 2011).

7. Conclusion

Strategic mine planning is the central technical–economic function in a mining feasibility study. It defines not only pit limits and schedules but also capital pathways, risk exposure, environmental and closure liabilities, and the long‑term relationship between the mine and its stakeholders.

Modern research shows that advanced stochastic optimization, geometallurgical integration, real options, and sustainability‑aligned cost models can materially increase NPV, reduce downside risk, and avoid large unforeseen liabilities. Conversely, suboptimal or naïve mine plans can forfeit tens of percent of potential value, misjudge risk of unprofitability, create costly operational and environmental problems, and undermine social license.

For high‑quality feasibility studies, strategic mine planning must therefore be rigorous, uncertainty‑aware, multi‑disciplinary, and grounded in both advanced optimization methods and sound professional judgment.


References

Marković, P., Stevanović, D., Kolonja, B., Slavković, D., & Kržanović, D., 2025. A Hybrid Model for Risk-Based Strategic Planning in Open-Pit Mining: Integrating Deterministic, Stochastic, and ISO 31000 Approaches. Applied Sciences. https://doi.org/10.3390/app15052500

Del Castillo, M., & Dimitrakopoulos, R., 2019. Dynamically optimizing the strategic plan of mining complexes under supply uncertainty. Resources Policy. https://doi.org/10.1016/j.resourpol.2018.11.019

Ali, M., & Rafique, Q., 2024. Strategic Integration of Real Options for Enhanced Valuation and Optimization in Mining Project Planning under Uncertainty: A Comprehensive Review. International Journal of Project Management. https://doi.org/10.47672/ijpm.2004

Amirshenava, S., & Osanloo, M., 2022. Strategic planning of post-mining land uses: A semi-quantitative approach based on the SWOT analysis and IE matrix. Resources Policy. https://doi.org/10.1016/j.resourpol.2022.102585

King, B., 2011. Optimal mining practice in strategic planning. Journal of Mining Science, 47, pp. 247-253. https://doi.org/10.1134/s1062739147020110

Sanders, J., & Fitzpatrick, A., 2022. A Peruvian case study: optimising mine planning through mine closure decision assessment. Mine Closure 2022: 15th Conference on Mine Closure. https://doi.org/10.36487/acg_repo/2215_51

Kopacz, M., Malinowski, L., Kaczmarzewski, S., & Kamiński, P., 2020. Optimizing mining production plan as a trade-off between resources utilization and economic targets in underground coal mines. Gospodarka Surowcami Mineralnymi – Mineral Resources Management. https://doi.org/10.24425/gsm.2020.133948

Morales, N., Seguel, S., Caceres, A., Jélvez, E., & Alarcón, M., 2019. Incorporation of Geometallurgical Attributes and Geological Uncertainty into Long-Term Open-Pit Mine Planning. Minerals. https://doi.org/10.3390/min9020108

Pouresmaieli, M., Ataei, M., Qarahasanlou, A., & Barabadi, A., 2023. Integration of renewable energy and sustainable development with strategic planning in the mining industry. Results in Engineering. https://doi.org/10.1016/j.rineng.2023.101412

Malundamene, M., Habib, N., Soulaimani, S., Abdessamad, K., & Askari-Nasab, H., 2024. State-of-the-art optimization methods for short-term mine planning. F1000Research, 13. https://doi.org/10.12688/f1000research.152986.2

Oliveros-Sepúlveda, D., Bascompta-Massanés, M., & Franco-Sepúlveda, G., 2025. Environmental and Closure Costs in Strategic Mine Planning, Models, Regulations, and Policies. Resources. https://doi.org/10.3390/resources14030041

Fernanda, M., Castillo, D., Dimitrakopoulos, R., & Maulen, M., 2024. Adaptive Simultaneous Stochastic Optimization of the Escondida Mining Complex, Chile. Mining, Metallurgy & Exploration, 41, pp. 2787 – 2799. https://doi.org/10.1007/s42461-024-01092-1

Sepúlveda, G., Álvarez, P., & Bedoya, J., 2020. Stochastic optimization in mine planning scheduling. Comput. Oper. Res., 115, pp. 104823. https://doi.org/10.1016/j.cor.2019.104823

Afum, B., & Ben-Awuah, E., 2021. A Review of Models and Algorithms for Surface-Underground Mining Options and Transitions Optimization: Some Lessons Learnt and the Way Forward. **, 1, pp. 112-134. https://doi.org/10.3390/mining1010008

Quelopana, A., Órdenes, J., Araya, R., & Navarra, A., 2023. Geometallurgical Detailing of Plant Operation within Open-Pit Strategic Mine Planning. Processes. https://doi.org/10.3390/pr11020381

Dowd, P., Xu, C., & Coward, S., 2016. Strategic mine planning and design: some challenges and strategies for addressing them. Mining Technology, 125, pp. 22 – 34. https://doi.org/10.1179/1743286315y.0000000032

Mata, J., Nader, A., & Mazzinghy, D., 2022. Methodology to include the comminution specific energy into open-pit strategy mine planning using global optimization. Tecnologia em Metalurgia, Materiais e Mineração. https://doi.org/10.4322/2176-1523.20222752
